Automated Onboarding Automated Onboarding
IT Asset Management IT Asset Management
Automated Offboarding Automated Offboarding
Device Storage Device Storage
Automated Onboarding

One dashboard to procure IT hardware assets to your global workforce.

Global delivery and MDM enrollment, all ready for your new hire’s day 1.

Enable your employees to order equipment and reduce your admin workload.

Sync with your HR system to prevent duplicate work and make onboarding smoother.

IT Asset Management

Automate device enrollment and ensure security compliance.

Real-time visibility into asset locations and status.

Track the performance and value of devices throughout their lifecycle.

Centralized dashboard to manage device repairs and replacements.

Store, track, organize, and manage your IT inventory.

Automated Offboarding

Automated collection of devices from departing employees globally.

Certified data erasure to protect sensitive information and stay compliant.

Reuse refurbished offboarded equipment to reduce waste.

Eco-friendly disposal of end-of-life assets in compliance with local regulations.

Sustainable recycling of IT assets to minimize environmental impact.

Device Storage

Local storage facilities to store IT assets and manage logistics efficiently.

Real-time stock tracking and automated restocking across all warehouses.

Quick access to devices stored in local warehouses for distribution.

Company

From scale-ups to global corporates, the world's most forward-thinking companies use Workwize to power their remote teams.

Contact Us

TABLE OF CONTENTS

    Share Article

    Why are procurement contracts essential? Definition, types & lifecycle

    Edited & Reviewed

    TL;DR: Procurement contracts at a glance

    • Procurement contracts define expectations and accountability between IT teams and vendors.

    • Structure matters: clear SOWs, pricing, SLAs, and termination clauses reduce risk.

    • Contract types vary: use fixed-price, T&M, or hybrid based on scope.

    • Lifecycle steps ensure continuity, from needs assessment to renewal.

    • Workwize is the number one automation platform to manage IT assets—from procurement to deployment, retrieval, and certified disposal—across geographies.

    What is a procurement contract?

    A procurement contract is a legally binding agreement between a buyer and a supplier that defines the price, scope, delivery terms, and responsibilities for goods or services.

    These contracts ensure clarity, prevent disputes, and align teams on expectations, especially critical for global IT asset management and procurement workflows.

    More than just paperwork—they're the silent engines that keep your organization running smoothly.

    Especially in a global IT setup, these agreements dictate how laptops arrive on time, how vendor relationships are managed, and how risks are minimized.

    Why clarity in procurement contracts matters

    Imagine onboarding 50 new employees across five countries, only to realize that your supplier misunderstood the shipping timeline—or worse, the pricing terms were never confirmed. The result? Delays, disputes, and budget blowouts.

    Here's what commonly goes wrong:

    • Delays: Ambiguities around lead times and delivery responsibilities disrupt workflows.

    • Disputes: Unclear expectations open the door to miscommunication.

    • Budget overruns: Unexpected surcharges or scope creep strain the bottom line.

    Procurement contracts convert high-level strategy into enforceable action. They outline expectations, define ownership, and ensure everyone—procurement, legal, IT, finance—is aligned.

    Core objectives of procurement contracts

    • Clarity: Avoid misunderstandings with precise definitions of scope and deliverables.

    • Accountability: Assign responsibilities to each party with measurable outcomes.

    • Protection: Guard against delivery failures, quality issues, or legal disputes.

    When are procurement contracts used?

    • One-time purchases: E.g., buying ergonomic chairs for a remote office setup.

    • Long-term vendor engagements: Managed services like workstation provisioning.

    • Service outsourcing: IT support contracts, device repairs, etc.

    What is the difference between digital vs traditional procurement contracts

    Feature

    Traditional contracts

    Digital contracts

    Format

    Static PDFs or Word files

    Dynamic, cloud-based forms

    Accessibility

    Local or email-based

    Centralized platforms

    Version Control

    Manual tracking

    Automated versioning

    Approval Workflow

    Email chains or sign-off sheets

    Built-in digital workflows

    Metadata Tagging

    Absent or manual

    Automatic tagging (dates, owner, category)

    Searchability

    Hard to find

    Keyword and filter search

    Integration

    Standalone

    Integrated with procurement and asset tools

    Go beyond purchase orders.

    Most tools stop at buying. Workwize automates procurement, asset management, deployment, retrieval, and even disposal—globally.

    Why procurement contracts matter



    Procurement contracts do more than formalize an agreement—they shape your operational reliability.

    1. Clarity and precision

    Example: A scope of work stating “delivery of laptops” is vague. A precise one would list make, model, quantity, and configuration requirements.

    2. Risk management

    Contracts allow you to define penalties for delays or subpar performance. For instance, an SLA breach could trigger a 5% payment deduction.

    3. Accountability and governance

    Including KPIs (e.g., % on-time delivery) or SLAs (e.g., 48-hour device replacement) provides measurable benchmarks.

    4. Professionalism and trust

    Suppliers are more willing to prioritize you when contracts are professionally managed. It shows you’re serious.

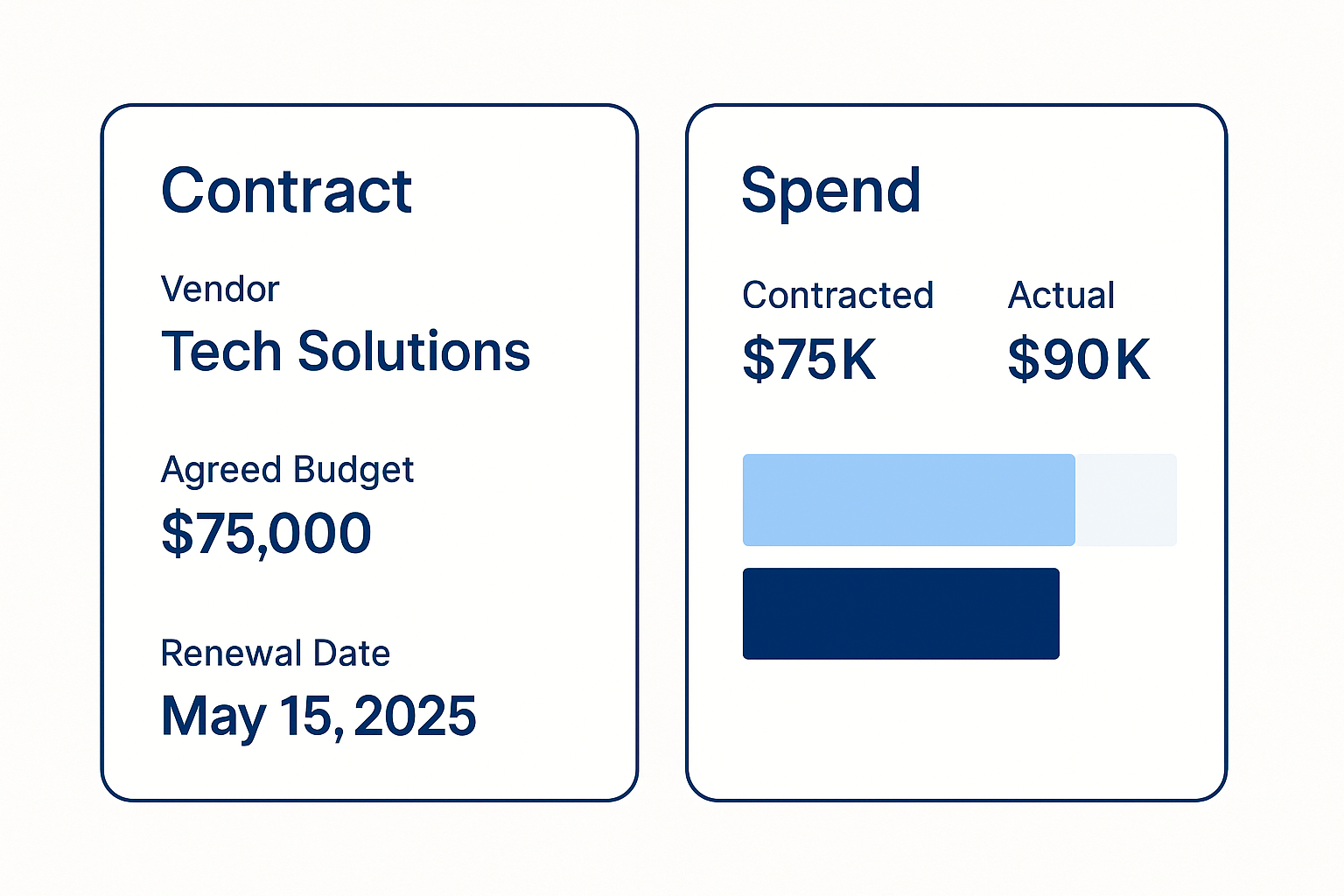

    5. Auditability

    Contracts make audits easier. For example, during a financial audit, you can trace why a device purchase exceeded budget—was it a scope change or a contract oversight?

    Structure of a procurement contract

    Generated image



    A well-structured procurement contract is the foundation of operational success. It ensures both parties are aligned on what is being delivered, how, and under what terms—avoiding surprises later in the process.

    Scope of work (SOW)

    • Defines the deliverables with precision, stating what is included and explicitly what is not.

    • Example: Instead of saying “supply of laptops,” use “supply of 100 MacBook Air M2, with 16GB RAM, 512GB SSD, and pre-enrolled in Apple Business Manager.”

    • A good SOW leaves no room for guesswork.

    Pricing and payment terms

    • Details fixed vs. variable pricing, unit costs, and applicable discounts.

    • Example: "$850 per unit with a 5% discount on orders above 100 units."

    • Also includes payment schedules, milestone-based billing, and penalties for late payments or delivery.

    Delivery and performance expectations

    • Specifies delivery timelines, locations, Incoterms, and SLAs.

    • Performance expectations often include on-time delivery rates, configuration standards, and warranty support.

    • Example: “Devices must be delivered to EU warehouses within 5 business days, with serial numbers reported within 24 hours.”

    Receipt & acceptance

    • Outlines inspection protocols, timelines for reporting issues, and criteria for rejecting goods.

    • Example: "Devices will be visually inspected within 48 hours. Items with broken screens or missing accessories will be rejected and returned."

    Contract duration

    • Clearly states start and end dates, with provisions for renewal and review cycles.

    • Includes escalation paths for contractual issues.

    • Example: “Initial term is 12 months with automatic renewal unless terminated with 30 days’ notice.”

    Termination clauses

    • Covers both termination for cause (e.g., breach of SLA) and for convenience.

    • Includes notice periods, financial implications, and return-of-goods procedures.

    • Example: “Either party may terminate with 60 days’ notice. If terminated early, prorated service fees apply.”

    Dispute resolution

    • Defines the legal jurisdiction, arbitration mechanisms, and timelines for resolving disagreements.

    • Example: “All disputes shall be resolved through arbitration in London within 30 days of written notification.”

    Confidentiality & IP rights

    • Protects proprietary information and defines how intellectual property will be treated.

    • Example: “Supplier will not reuse or resell custom imaging configurations developed for the buyer.”

    • Includes NDA clauses and data handling obligations.

    Force majeure

    • Provides relief for parties when unforeseen events occur, such as natural disasters, pandemics, or political unrest.

    • Example: “Neither party shall be liable for failure to perform if caused by events beyond reasonable control, including supply chain disruptions.”

    Amendments

    • Explains how changes to the agreement are made, documented, and approved.

    • Requires formal documentation of revisions with version control.

    • Example: “All amendments must be mutually agreed in writing and attached as a contract addendum with revision date.”

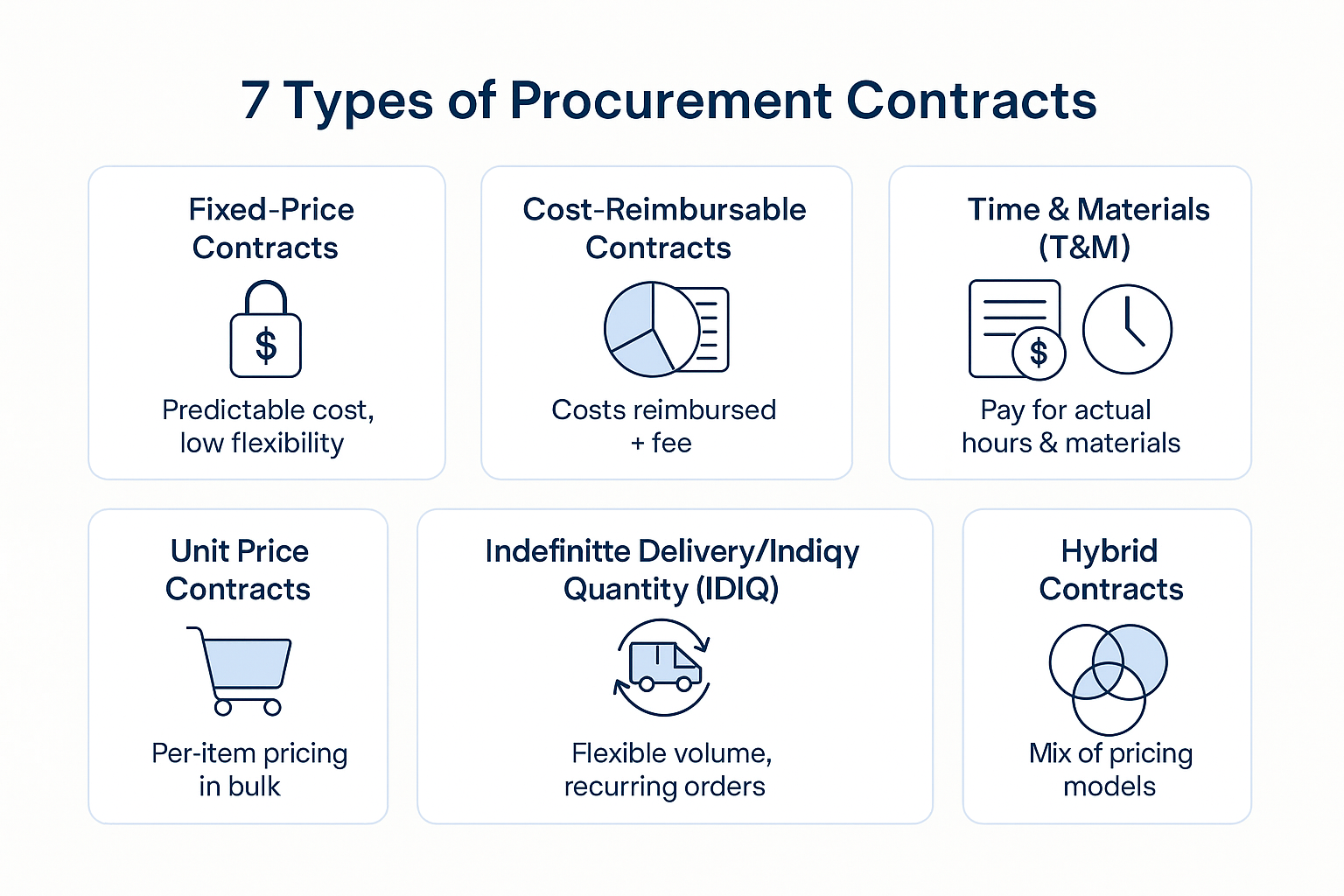

    7 Types of procurement contracts





    1. Fixed-price contracts

    Suitable for well-defined, predictable projects where outcomes are known upfront. The supplier agrees to deliver specific goods or services at a set price, reducing cost uncertainty for the buyer but limiting flexibility if requirements change.

    2. Cost-reimbursable contracts

    The buyer agrees to cover allowable costs incurred by the supplier, plus an additional fee. Ideal for innovation projects, but needs strict oversight to avoid budget overruns due to low cost discipline.

    3. Time & materials (T&M)

    Payment is based on actual hours worked and materials used. This contract offers flexibility for undefined scopes but puts the financial risk on the buyer if the work expands unexpectedly.

    4. Unit price contracts

    Used for purchasing items in bulk, each priced per unit. It’s efficient for predictable items like peripherals, but incorrect demand estimates can lead to overspending or inventory shortages.

    5. Indefinite delivery/indefinite quantity (IDIQ)

    Enables orders within an agreed quantity range over time. It suits unpredictable demand cycles, such as device deployments for growing teams, but needs strong ordering governance.

    6. Guaranteed maximum price (GMP)

    Sets a cap on the project cost. If actual costs are below the cap, savings go to the buyer. Useful for large, defined projects but may incentivize suppliers to inflate cost estimates.

    7. Hybrid contracts

    Combines elements like fixed pricing with incentive fees or T&M billing. These are great for evolving relationships that start structured but require flexibility over time.

    Visual matrix

    Type

    Best for

    Benefit

    Challenge

    FFP

    Defined scopes

    Budget certainty

    Inflexible

    CPIF

    R&D

    Innovation

    Cost risk

    T&M

    Short-term needs

    Simplicity

    Buyer risk

    IDIQ

    Ongoing demand

    Flexibility

    Oversight needed

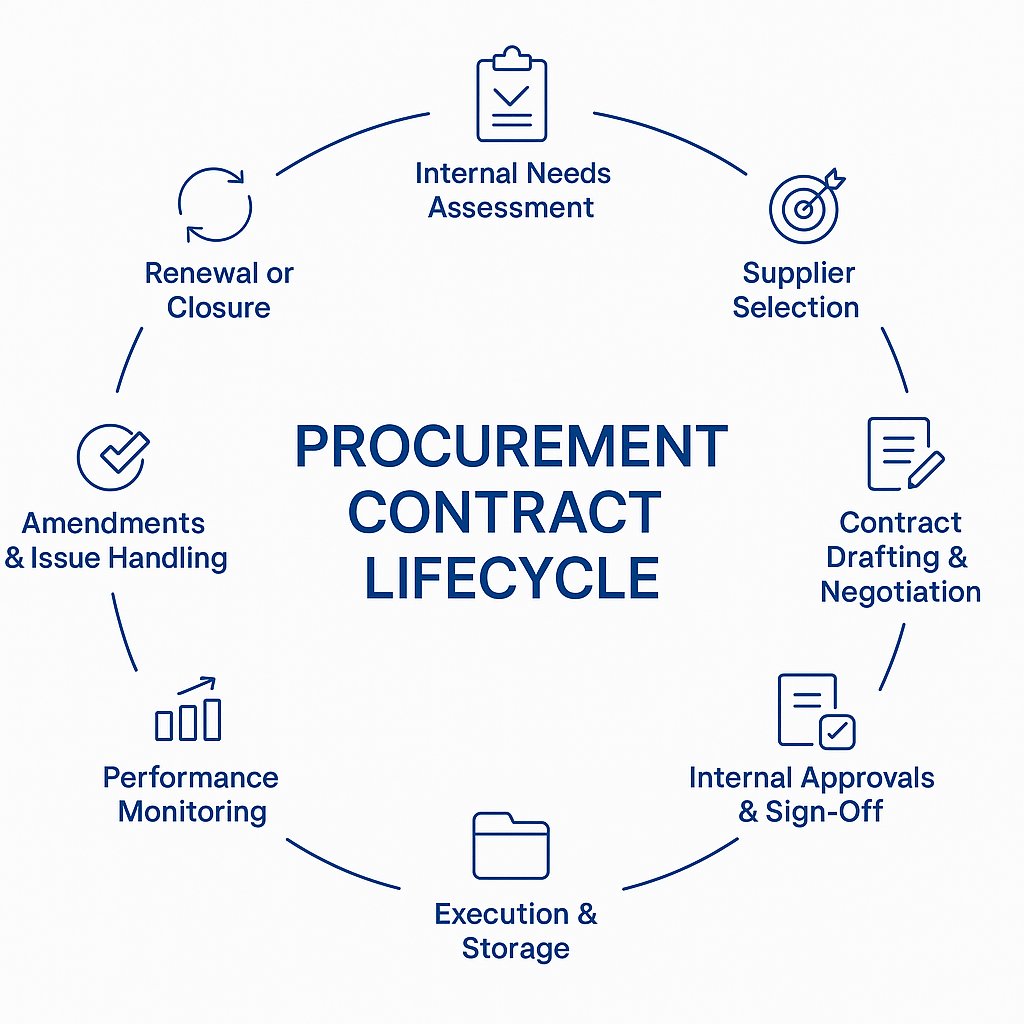

    What does the procurement contract lifecycle look like?





    1. Internal needs assessment

    Start by asking: what exactly do we need to procure, and why? Engage all relevant stakeholders—from IT to Finance—to identify priorities, risks, and compliance requirements. For instance, if your IT team is onboarding 200 remote employees, procurement needs to know which devices are needed, lead times, and preferred vendors.

    2. RFQ/RFP development

    Depending on the complexity, draft a Request for Quotation (RFQ) for straightforward buys, or a Request for Proposal (RFP) when evaluating service providers. Include specs, evaluation criteria, and timelines. If sourcing zero-touch laptops for multiple countries, outline MDM compatibility, delivery SLAs, and local compliance needs.

    3. Supplier selection

    Use a balanced scorecard approach: price, reliability, local availability, ESG practices, and references. For example, if one vendor offers cheaper pricing but poor lead times, it may be worth paying more for faster onboarding. Run pre-qualifications for niche needs like certified IT asset disposal.

    4. Contract drafting & negotiation

    This is where legal meets operations. Collaborate with your legal, finance, and IT teams to ensure coverage of KPIs, SLAs, warranty terms, and exit conditions. If working with Workwize, ensure MDM enrollment, delivery timelines, and warehousing options are clearly documented.

    5. Internal approvals & sign-off

    Use digital workflows—such as DocuSign or platform-native tools—to speed up sign-off. Ensure all stakeholders, especially legal and finance, have reviewed and approved. For high-value contracts, this may also require executive or board-level authorization.

    6. Execution & storage

    Once signed, the contract should be uploaded into a central repository—ideally one with tagging, keyword search, and reminders. Add metadata like contract owner, renewal date, and SLA indicators to keep it easy to manage.

    7. Performance monitoring

    Regularly review supplier performance against KPIs. If the contract guarantees five-day shipping, monitor if that’s being met. Set up alerts for missed deliveries, budget overruns, or SLA breaches. Consider quarterly business reviews with key suppliers.

    8. Amendments & issue handling

    Projects evolve. Maybe a new region needs to be added or a pricing model updated. Track all amendments formally. Use a change log with approval workflows to maintain compliance and reduce ambiguity.

    9. Renewal or closure

    As contracts near end-of-term, evaluate performance: did the vendor deliver on promises? If so, renew with revised terms. If not, initiate a new RFP or terminate with proper offboarding. Archive closed contracts for audit and knowledge retention.

    7 Best practices for contract management





    • Standardize templates: Develop a library of pre-approved contract templates tailored to different procurement categories (hardware, SaaS, consulting). This not only accelerates drafting but also ensures consistency and legal compliance across all contracts.

    • Contract repository: Store all contracts in a centralized, cloud-based system with robust search, tagging, and versioning features. This helps stakeholders quickly retrieve current agreements, track obligations, and conduct audits.

    • Ownership assignment: Every contract should have a clear owner—typically someone in procurement—responsible for managing its lifecycle. This person should monitor compliance, manage renewals, and coordinate amendments with relevant teams.

    • Automate reminders: Set up alerts for critical dates like renewal deadlines, review checkpoints, and SLA milestones. Use integrated tools to reduce the risk of contract lapses or overlooked obligations.

    • Link to spend: Integrate contracts with your financial systems or platforms like Workwize to track actual spend against agreed terms. This ensures transparency, reduces maverick spending, and makes it easier to evaluate supplier performance.

    • Audit regularly: Conduct scheduled legal, financial, and operational audits to ensure contracts remain up to date, compliant, and reflective of current needs. Spot-check performance against KPIs and rectify any discrepancies proactively.

    • Transition planning: Ensure all contracts include vendor offboarding procedures, asset return protocols, and data security requirements. When switching suppliers, use structured exit plans to minimize disruption and maintain business continuity. Don’t start from scratch. Use modular templates.

    🔥Procurement is the easy part— asset lifecycle control is the challenge.

    Workwize manages contracts and execution across all 5 stages: Procure → Deploy → Maintain → Retrieve → Decommission. That’s zero-touch IT, with audit-ready accountability baked in.

    About the authors:

    Simplify IT operations with Workwize
